How to make a timeline in Excel

Explore a detailed tutorial on how to create a timeline in Excel, from building a timeline chart in Excel step by step to using Excel timeline templates that speed up the process. You'll also learn how to automate timeline creation using a timeline generator.

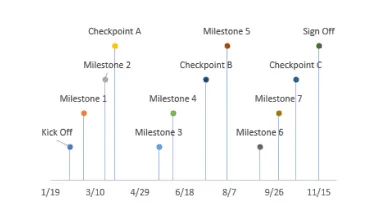

Timeline made with Office Timeline from Excel data

A timeline is a type of chart which visually shows a series of events in chronological order over a linear timescale. The power of a timeline is that it’s a visual representation, which makes it easy to understand critical milestones in a project and the progress of a project schedule. Timelines are particularly powerful for project scheduling or project management when paired with a Gantt chart, as shown at the end of this tutorial.

Video tutorial

How to create a project timeline in Excel

Play Video

Options for making an Excel timeline

Microsoft Excel has a Scatter chart that can be formatted to create a timeline. If you need to create and update a timeline for recurring communications with clients and executives, it would be simpler and faster to create a PowerPoint timeline.

On this page you can see both ways to create a timeline using these popular Microsoft Office tools. We will give you step-by-step instructions for making a timeline chart in Excel by formatting a Scatter chart. We will also show you how to instantly create an executive timeline in PowerPoint by pasting your project data from Excel. And if you'd rather skip the manual work, you'll find a curated set of Excel timeline templates, including a project management timeline template, further down the page.

How to create an Excel timeline in 7 steps

1. List your key events or dates in an Excel table.

a) List out the key events, important decision points or critical deliverables of your project. These will be called Milestones and they will be used to create a timeline.

b) Create a table out of these Milestones and next to each milestone add the due date of that particular milestone.

c) To create a timeline in Excel, you will also need to add another column to your table that includes some plotting numbers. Add the new column next to your milestone description column and list out a repetitive sequence of numbers such as 1, 2, 3, 4 or 5, 10, 15, 20 etc. Excel will use these plotting points to vary the height of each milestone when plotting them on your timeline template.

For this demonstration we’ll format the table in the image below into a Scatter chart and then into an Excel timeline. Then we’ll use it again to make a timeline in PowerPoint.

2. Make a timeline in Excel by setting it up as a Scatter chart.

a) From the timeline worksheet in Excel, click on any blank cell.

b) Then from the Excel ribbon, select the Insert tab and navigate to the Charts section of the ribbon.

c) In the Charts section of the ribbon drop down the Scatter or Bubble Chart menu.

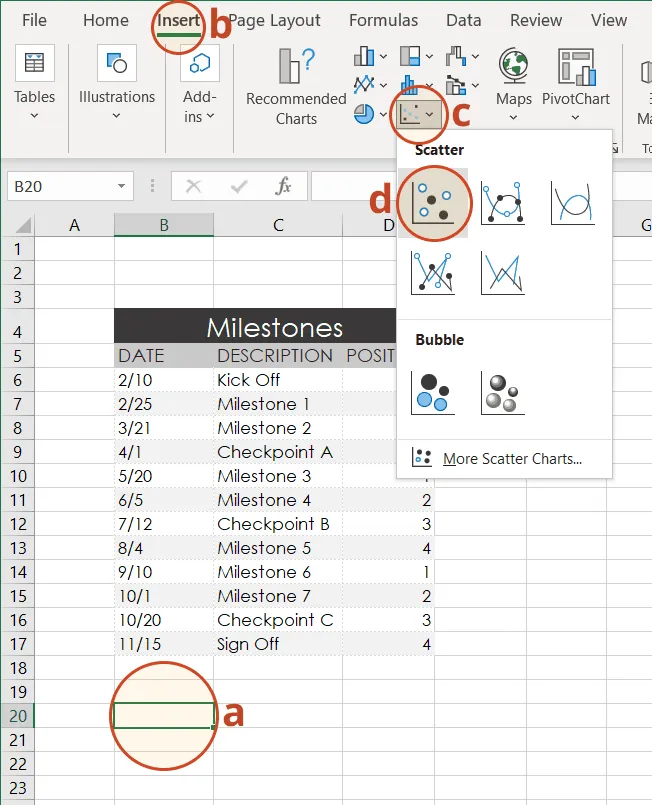

d) Select Scatter which will insert a blank white chart space onto your Excel worksheet.

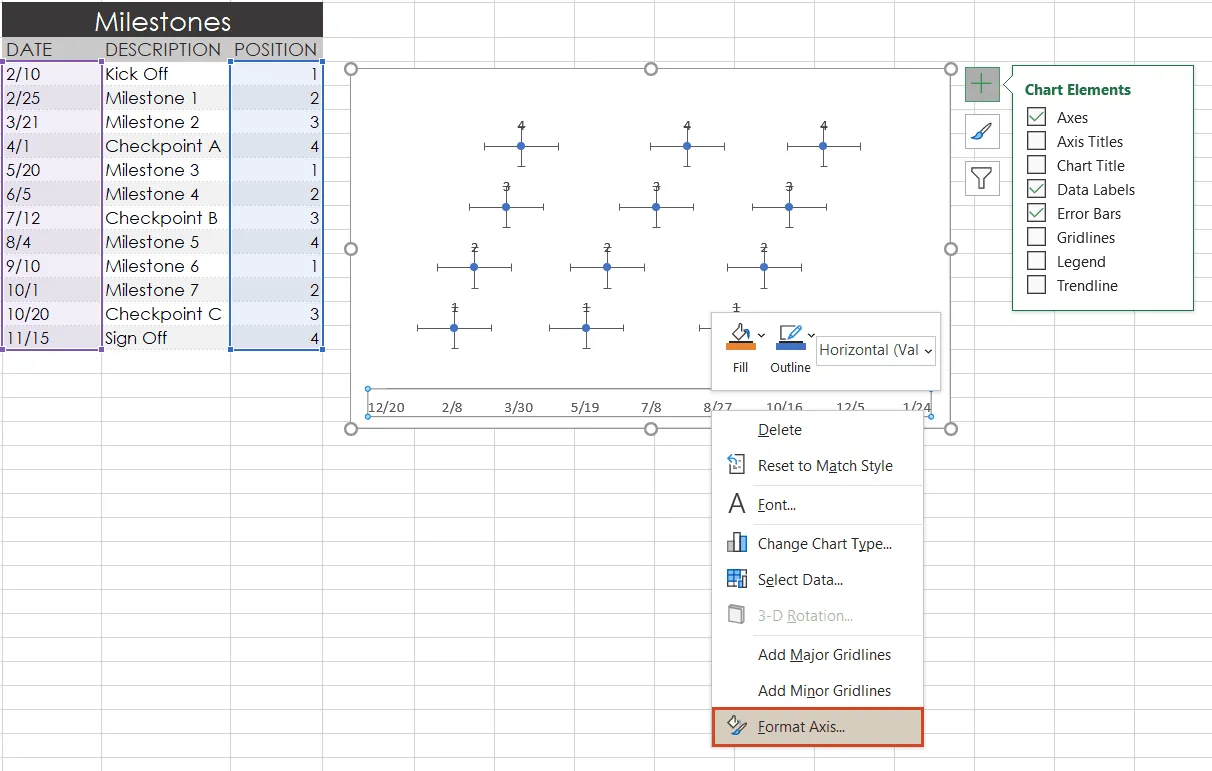

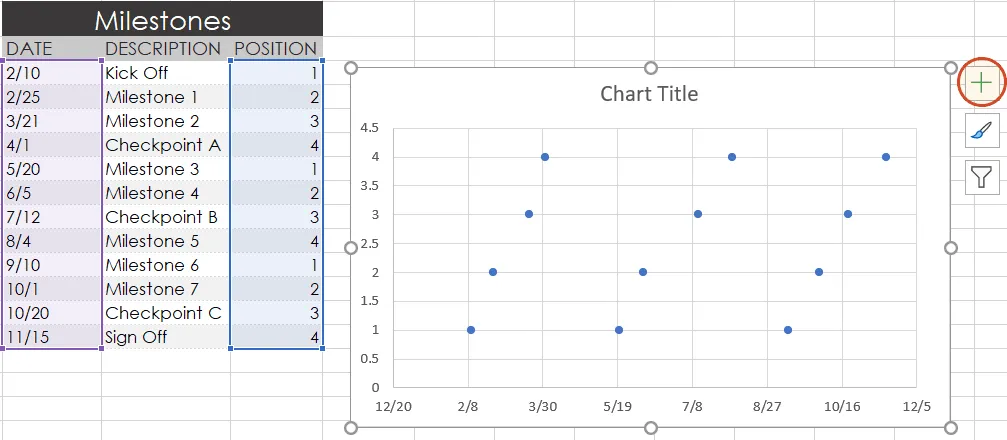

Insert Scatter chart to make Excel timeline

3. Add Milestone data to your timeline.

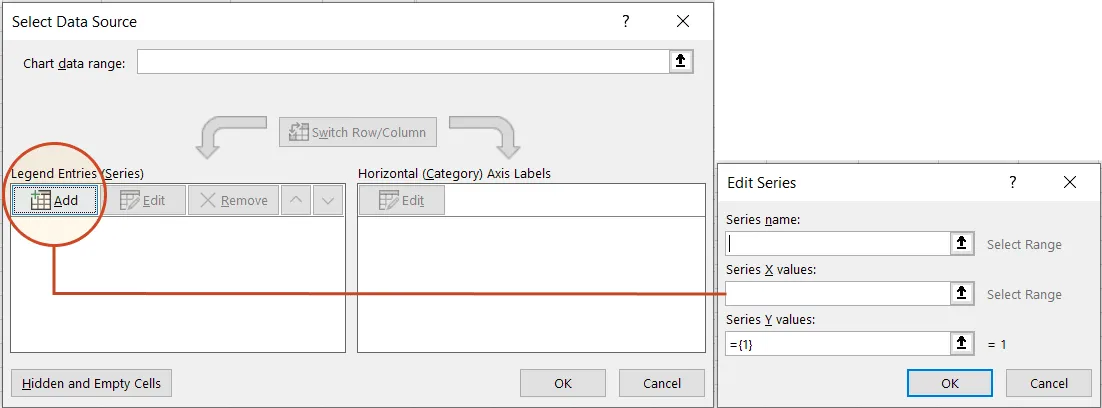

a) Right-click the blank white chart and click Select Data to bring up Excel's Select Data Source window.

Selecting timeline data in Excel

b) On the left side of Excel's Data Source window, you will see a table named Legend Entries (Series). Click on the Add button to bring up the Edit Series window. Here you add the dates that will make your timeline.

Select data source - edit series

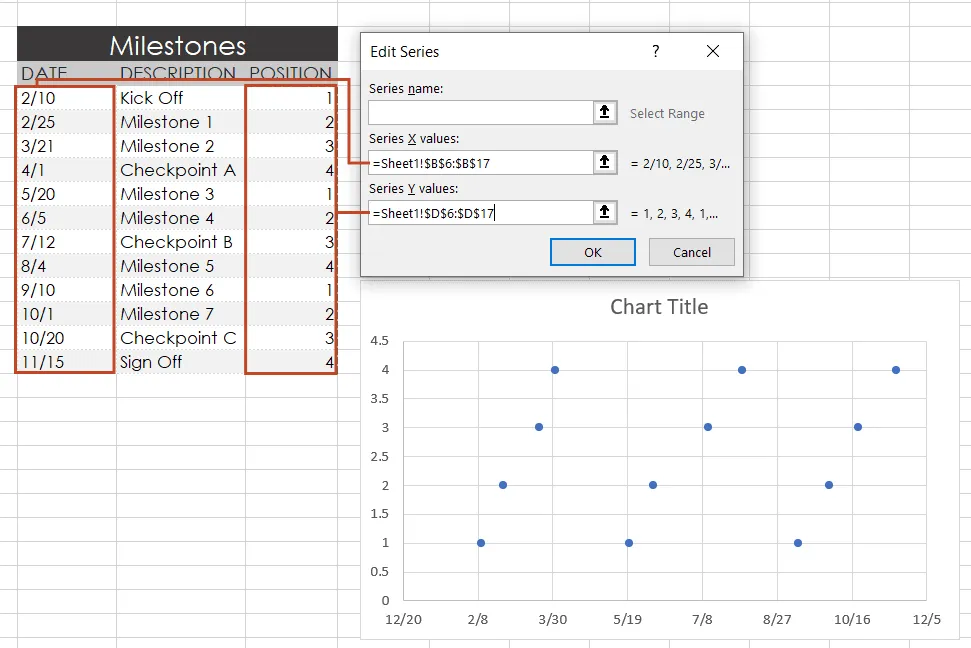

c) We will enter the dates into the field named Series X values . Click in the Series X values window on the arrow button.

Add data from Excel to make a timeline – the Series X box

Then select your range by clicking the first date of your timeline (ours is 2/10) and dragging down to the last date (ours is 11/15).

Following the same path, we will enter the plotting numbers series into the field named Series Y values. Click in the Series Y value window and remove the value

Add data from Excel to make a timeline – the Series Y box

that Excel places in the field by default. Then select your range by clicking on the first plotting number of your timeline (ours is 1) and then dragging down to the last plotting number of your timeline (ours is 4).

Edit series dialog to define data series for timeline chart in Excel

d) Click OK and then click OK again to create a scatter chart.

4. Turn your Scatter chart into a timeline.

a) Click on your chart to bring up a set of controls which will be presented to the upper right of your timeline's chart. Click on the Plus button (+) to open the Chart Elements menu.

Plus button in Scatter chart for Excel

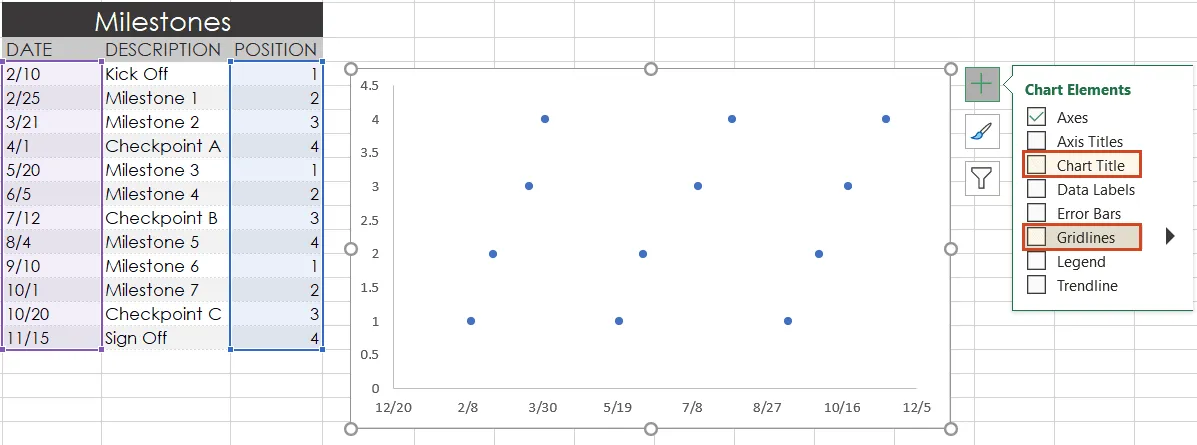

b) In the timeline's Chart Elements control box, uncheck Gridlines and Chart Title.

Chart Elements for Excel Timeline

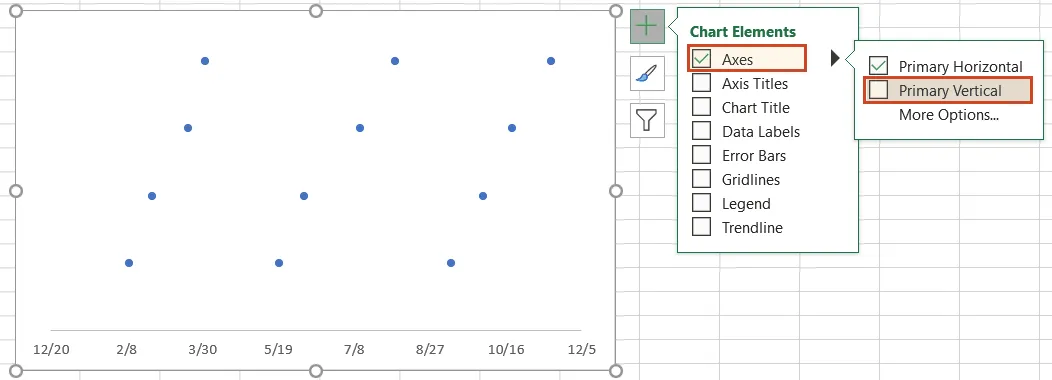

c) Staying in the Charts Elements control box, hover your mouse over the word Axes (but don't uncheck it) to get an expansion arrow just to the right. Click on the expansion arrow to get additional axis options for your chart. Here you should uncheck Primary Vertical but leave Primary Horizontal checked.

Uncheck Primary Vertical axe in Excel

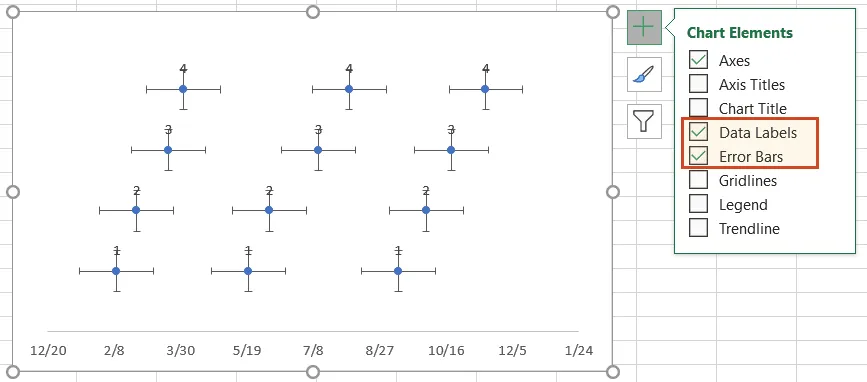

d) Staying in the Charts Elements control box just a little longer, add Data Labels and Error Bars.

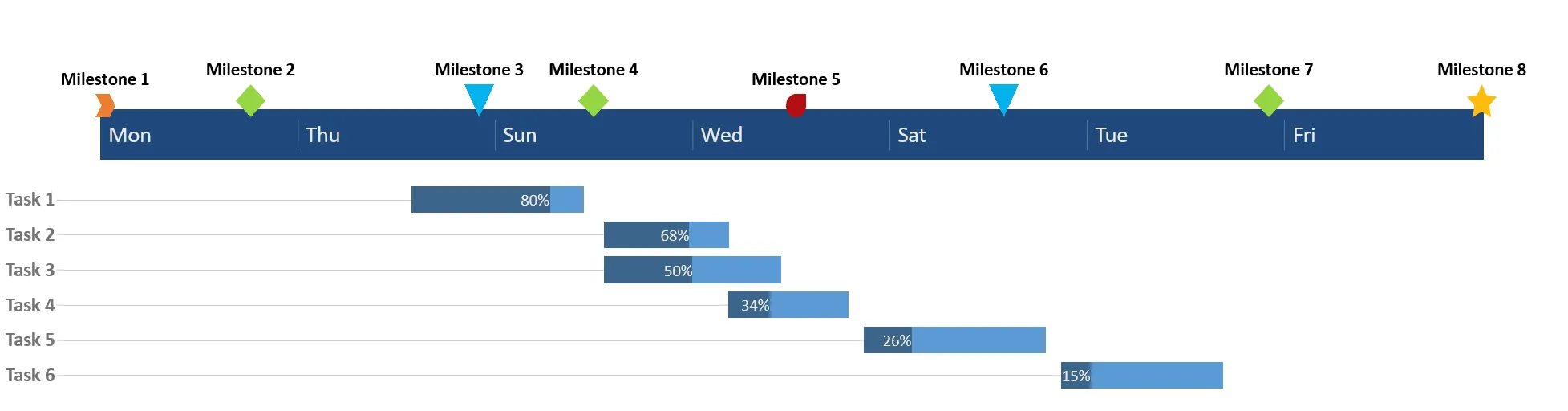

Your timeline chart should now look something like this:

Checking Data Labels and Error Bars in timeline chart for Excel

5. Format chart to look like a timeline.

a) To make a timeline in Excel, we will need to format the Scatter chart by adding connectors from your milestone points. Right-click on any one of the dates at the bottom of your timeline and select Format Axis to bring up Excel's Format Axis menu.

Select Format Axis to format timeline in Excel

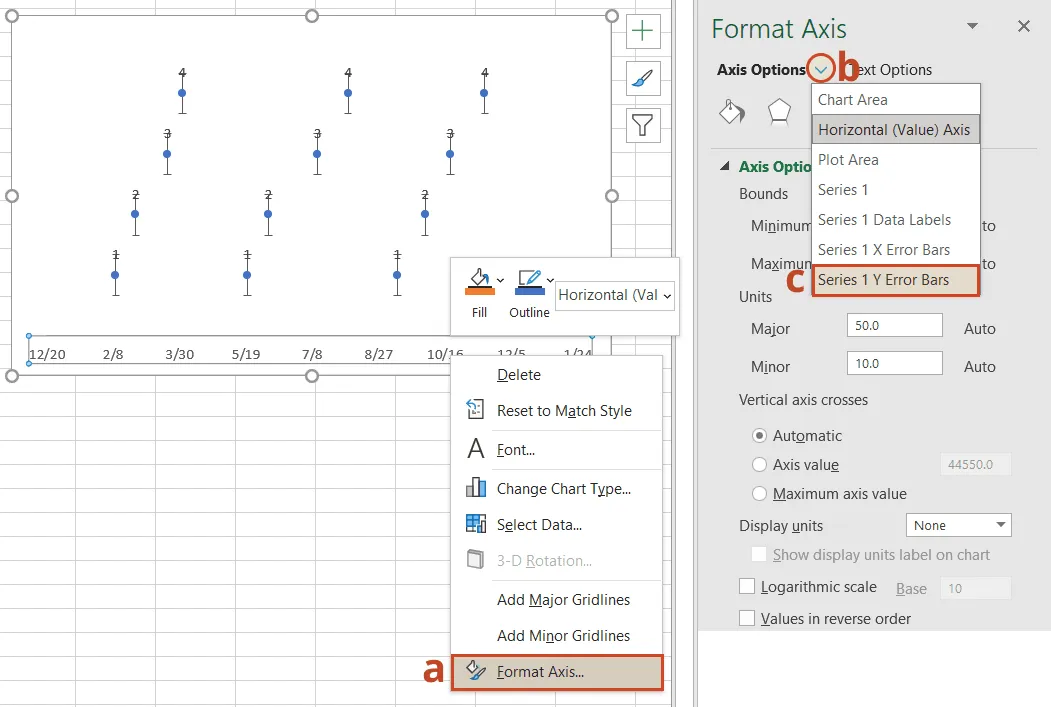

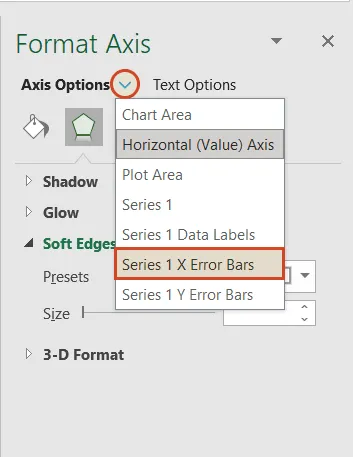

b) Drop down the arrow next to the title Axis Options and select Series 1 X Error Bars.

Axis Options settings on timeline chart for Excel

c) Under the Error Bar Options menu, click on the paint can icon to reveal the Fill & Line controls. Select No line, which will remove the horizontal lines around each of the plotted milestones on your timeline.

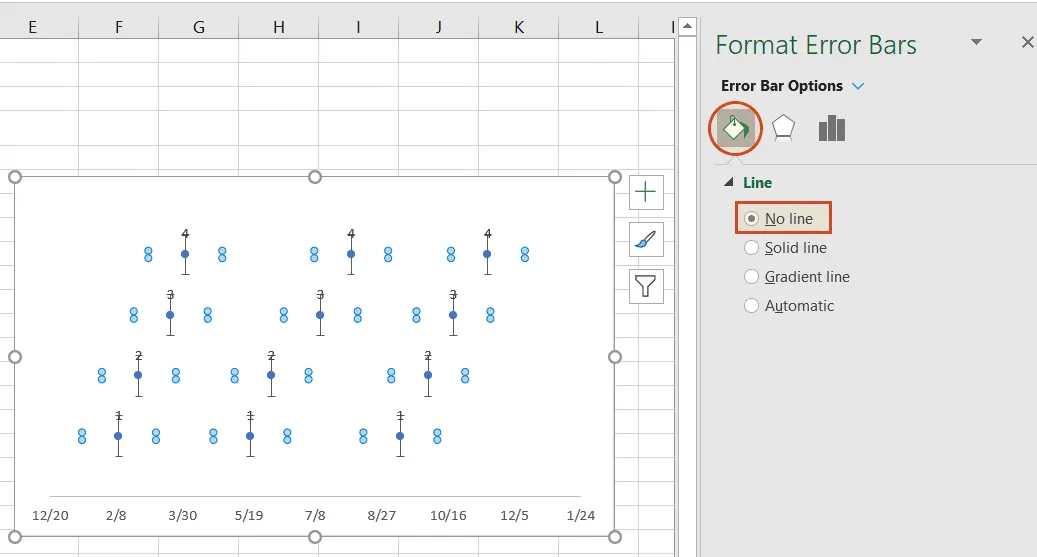

Selecting the No Line option in Format Error Bar – Excel timeline

d) In a similar process, we will also adjust your timeline's Y axis. Again, from the timeline, right-click on any one of your timeline's dates at the bottom of the chart and select Format Axis. Drop down the arrow next to the title Axis Options and select Series 1 Y Error Bars.

Steps to select option under Format Axis in Excel timeline

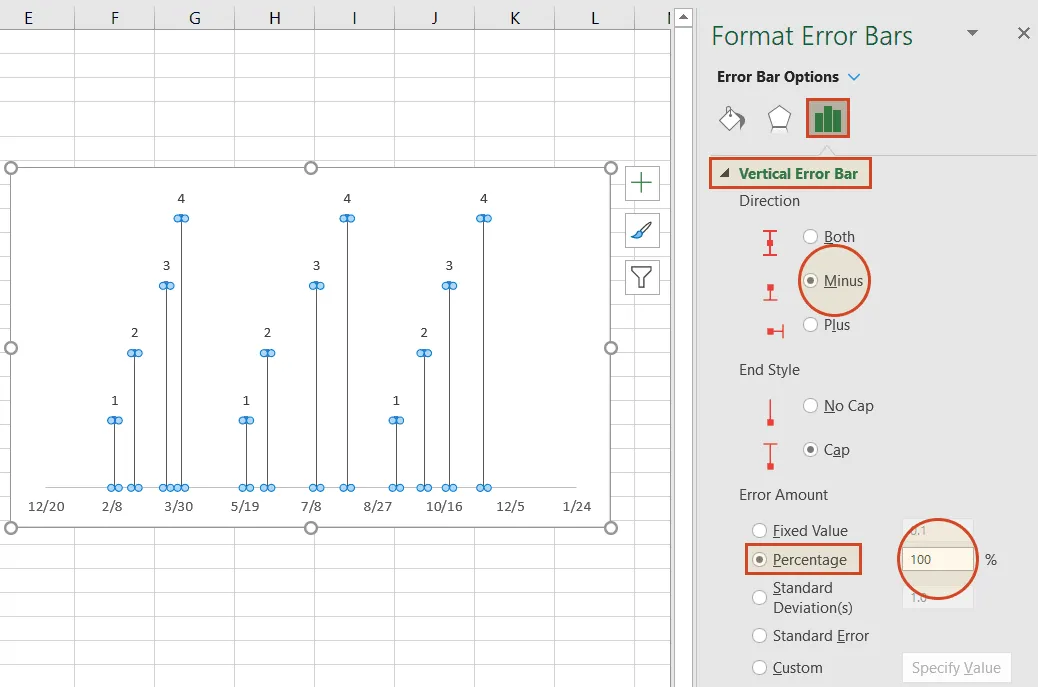

e) Right-clicking on any bar in the chart will open the Format Error Bars menu. From the Vertical Error Bar, set the direction to Minus. Then set the Error Amount to Percentage, and type in 100%. This will create connectors from your timeline's milestones to their respective points on your timeband.

Settings in Vertical Error Bar - Excel timeline

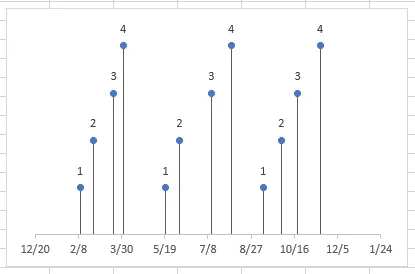

Your Excel timeline should now look something like the picture below.

Excel Timeline Intermediary version

6. Add titles to your timeline's milestones.

You have built a Scatter chart as an Excel timeline. Now we will format it into a proper timeline.

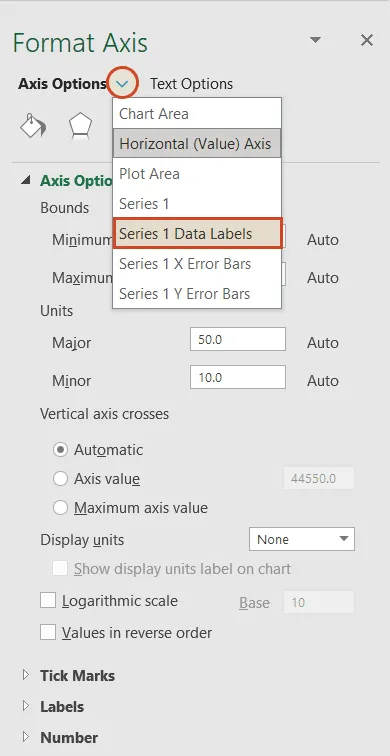

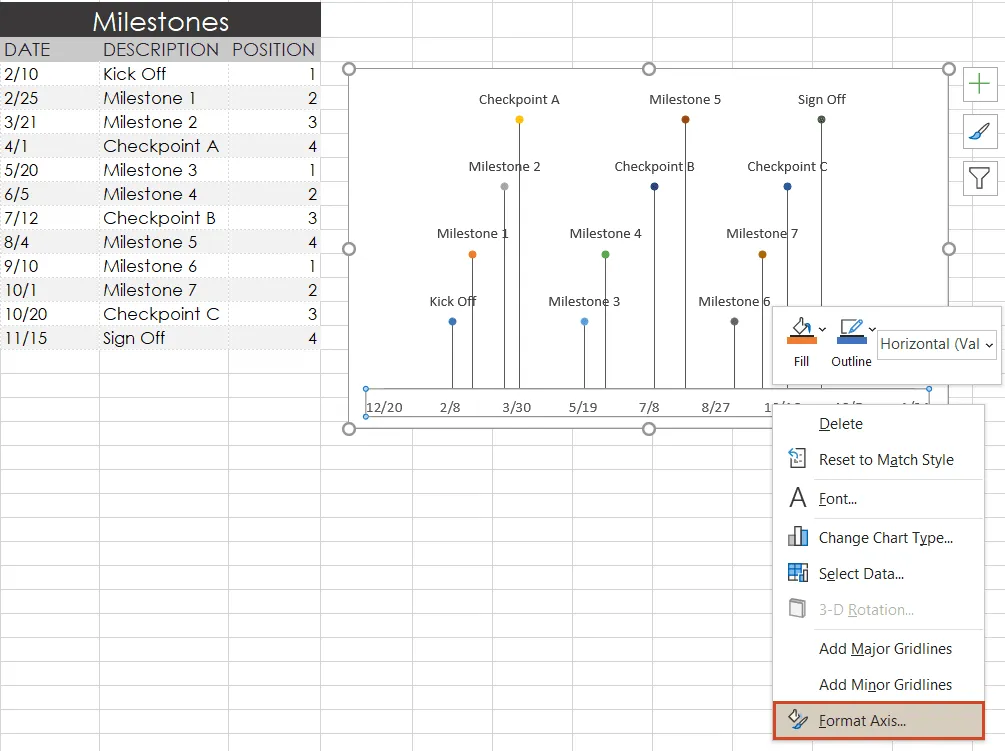

a) To finish making your timeline, we will add the milestone descriptions. Staying in the Format Axis menu, again drop down the menu arrow next to the title Axis Options. This time choose select Series 1 Data Labels to bring up the Format Data Labels menu.

Settings in Series 1 Data Labels in Format Axis - Excel timeline

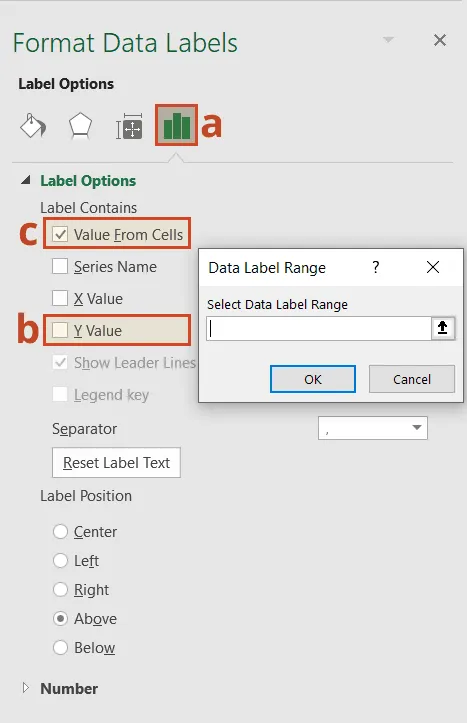

b) Click the Label Options icon. Uncheck Y Value, and then put a check next to Value From Cells. This will bring up an Excel data entry window called Data Label Range.

Selecting data range in Format Data Labels – Excel timeline

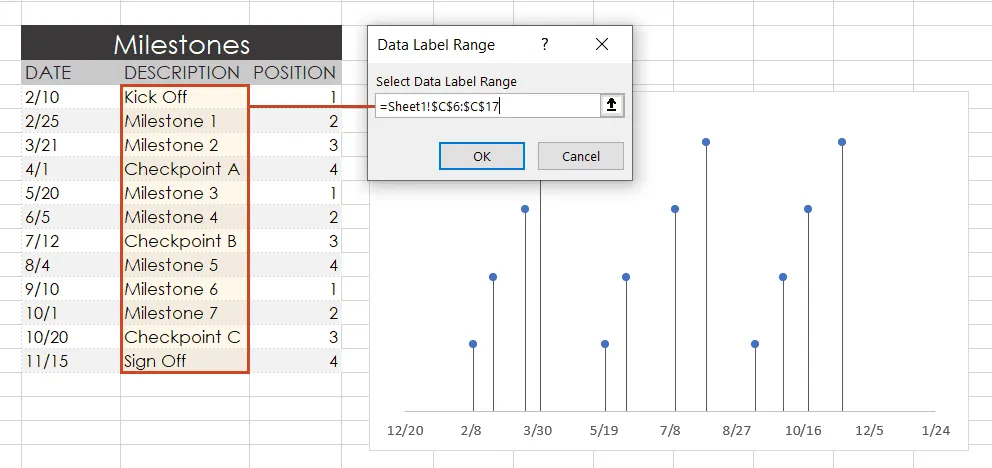

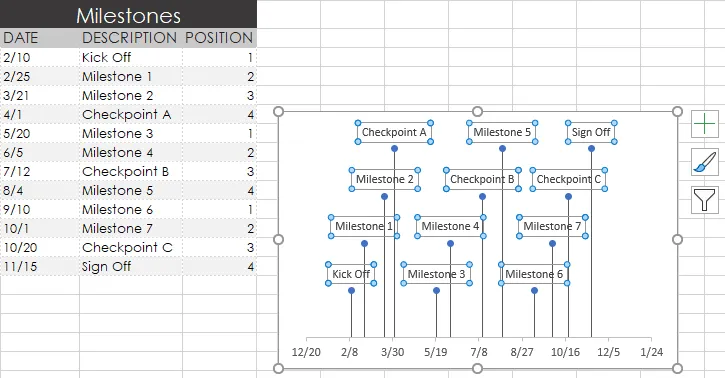

c) In the Select Data Label Range window, you will enter your timeline's milestone descriptions from the timeline table you built in step 1. To do this simply click on the description for the first milestone in your timeline table, (ours is Kick Off), then drag down to the last milestone in your timeline (ours is Sign Off). Click OK.

Timeline in Excel after selecting data label range

Your Excel timeline template should finally look more like this now:

Final Excel timeline after selecting data label range

7. Styling options for your timeline.

Now you can apply some styling choices to improve the aspect of your timeline.

a) Coloring your timeline's milestone markers.

From your timeline, right-click on any of the milestone points (caps) and select Format Data Series to bring up the Series Options menu.

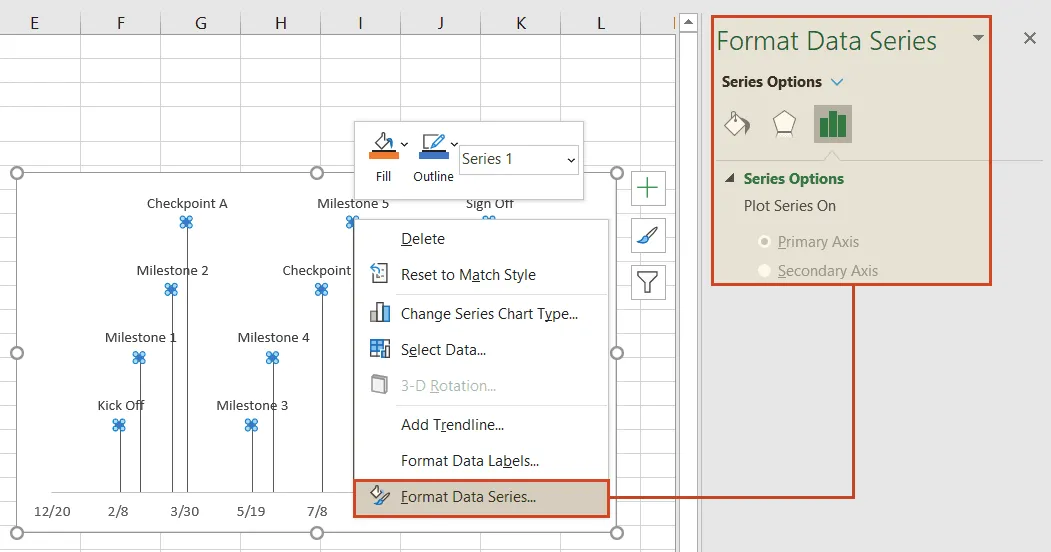

Bring up the Series Options menu in Excel timeline

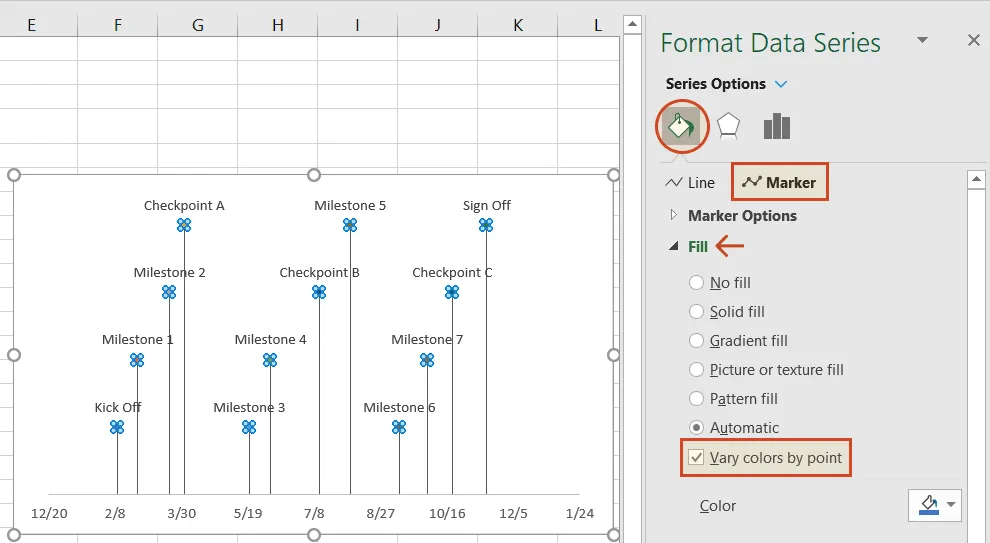

Select the paint can icon for Fill & Line options and, then choose the tab for Marker. You may also need to select Fill to reveal its menu. Then you can choose coloring options for your timeline's milestone markers. In our example, we selected Vary colors by point, which lets Excel pick the milestone colors for our timeline.

Change Excel timeline colors in Format Data Series

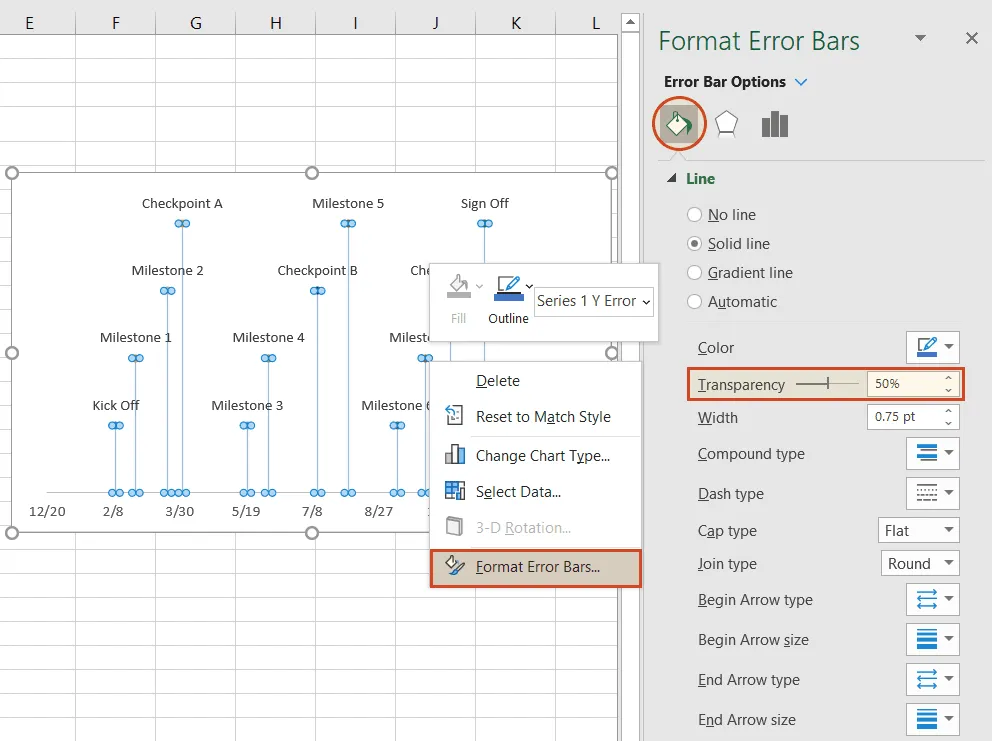

b) Change the vertical connector's transparency.

On your timeline, right-click on any of the vertical connectors that connect your milestones with the timeband below. Select Format Error Bars to bring up the Vertical Error Bar menu. Again, select the paint can icon to choose Excel's Line & Fill options. Here you can make formatting adjustments (color, size, style, etc.) to your timeline's connector lines. In our example we set the transparency of the lines to 50%.

Change Excel timeline connector transparency

c) Vary the height of each milestone so their descriptions are not overlapping the neighboring milestone.

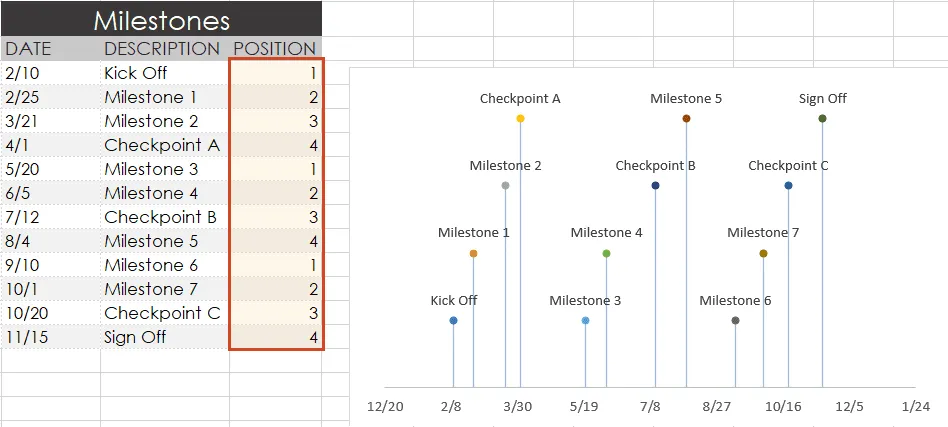

Remember the repeated sequence of numbers you added to your timeline table in step 1. Well, those set the height of each milestone on your timeline. By adjusting these numbers, you can play around with different height positions for each milestone. For example, to optimize our timeline, we used the number sequence, 1, 2, 3, 4, 1, 2, 3, 4.

Sequence of milestones positions on the Excel timeline

Look how the descriptions would overlap if we changed the order (Don’t try this at home! 😊):

Changed sequence of milestones position on the Excel timeline

d) Trim off the empty space to the left or right of your Excel timeline by adjusting its minimum and maximum bounds.

Again right-click on any of the dates below your timeband. Select Format Axis.

Access Format Axis to trim empty space on the Excel timeline

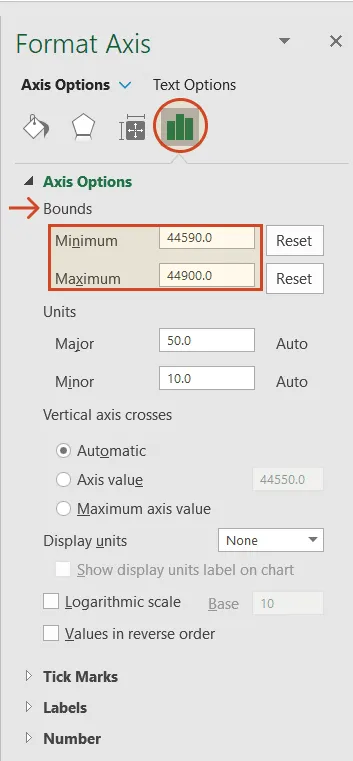

Under the heading Bounds, adjusting the Minimum number upward will move your first milestone left on your timeline, closer to the vertical Axis. Likewise, adjusting the Maximum number down will move your last milestone right on your timeline, closer to the right edge of your chart.

Adjusting Excel timeline bounds

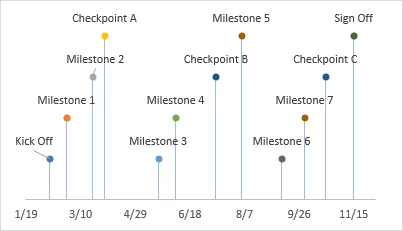

Finished! Our timeline now looks like this:

Final Excel timeline

Download a pre-built Excel timeline file

To help you get started quickly, we have included a free project timeline Excel template that you can download and customize. It's a good way to learn how to create a project timeline in Excel without building everything from scratch.

Get this free timeline template

Download Excel file

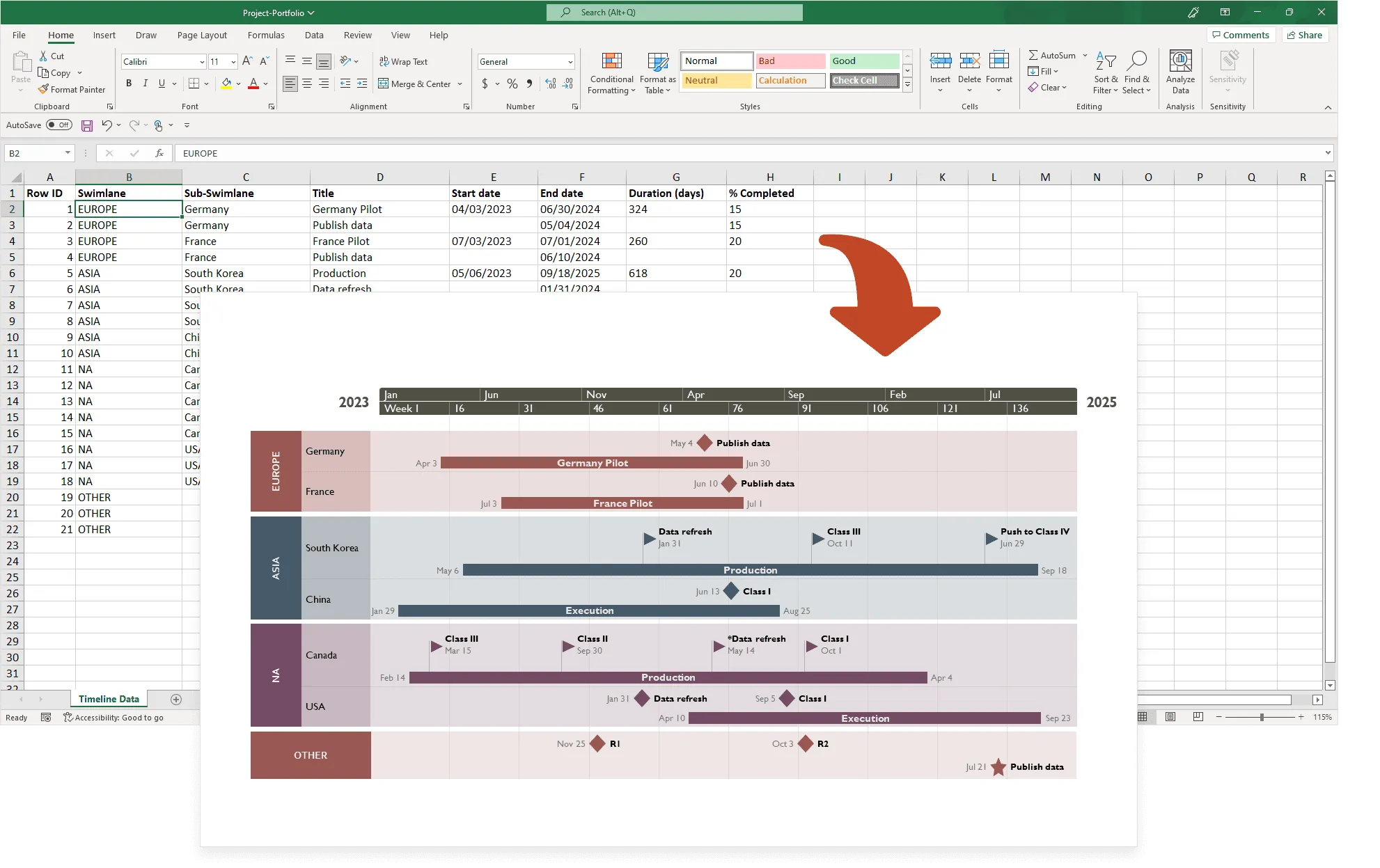

Make a great looking timeline from Excel directly in PowerPoint

Building timelines manually in Excel works, but it's still time-consuming if you need professional, presentation-ready visuals on a recurring basis. For teams that rely on a project management timeline template to communicate schedules, an automated approach saves hours of formatting.

If you prefer to stick to spreadsheets, we’re developing Office Plan, an Excel-based add-in (currently in Beta) that helps you create project timelines natively – no switching tools required.

For now, our suggestion for a faster, more polished result is to use a timeline tool like the Office Timeline add-in for PowerPoint. With it, you can paste the Excel table you created above straight into PowerPoint and instantly generate a timeline that you can present to clients or executives. To begin, you will need to install Office Timeline, which will add a timeline creator tab to PowerPoint.

1. Open PowerPoint and paste your table into the Office Timeline wizard.

a) Inside PowerPoint, click on the Office Timeline tab, and then click the New icon.

Office Timeline Ribbon

This will open a gallery where you can choose between various timeline styles, stock templates and even custom templates.

Built-in template gallery in Office Timeline

b) From the gallery, double-click the style or template you wish to use for your timeline to open its preview window and then select Create timeline. (You can find more designs in our timeline templates library.) For this demonstration, we will choose the Software Development timeline template. If you prefer to import and refresh your Excel table, rather than copy-paste, click on the Import button in the preview window.

Office Timeline Template in PowerPoint

c) Copy the data from Excel

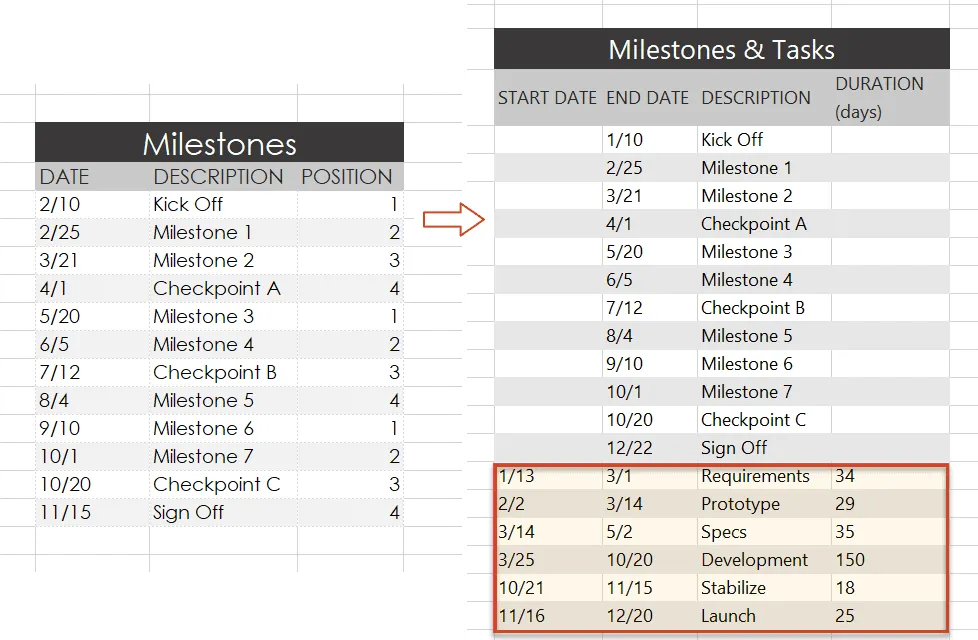

We have updated our data a bit, so that we get the timeline, but also a more detailed view of our project: we deleted the Timeline column, as we don’t need it, and added a list of tasks (with start and end dates and duration).

Format project data in Excel

Copy the data from your Excel table, but make sure not to include the column headers.

Copy data from Excel to Office Timeline

d) Now, simply paste the section into PowerPoint by using the Paste button in the upper-right corner of the Edit Data wizard.

Office Timeline Template in PowerPoint

Make edits if necessary (such as changing milestone shapes and colors or adding and removing items) and click the Create button.

2. Instantly, you will have a new timeline slide in PowerPoint.

a) Depending on the template or style you selected from the gallery, you will have a timeline similar to this:

Timeline made with Office Timeline from Excel data

b) You can easily customize the timeline further using Office Timeline. In our example above, we added percent complete, removed the Today’s Date marker, changed milestones, adjusted colors, and added tasks to create a Gantt chart.

Download PowerPoint timeline template file

If you’d like to use the timeline created in this guide as a template to help you move faster, you can download the file below, free of charge.

Get this free timeline template

Download PowerPoint file
Video tutorial

See how to make a PowerPoint timeline from Excel in under 2 minutes:

Play Video

You can also use Office Timeline’s online timeline maker to easily build timelines and other similar visuals that you can instantly update and share with executives and teams.
